Serving Greater Eden Prairie

Condo and Townhome Flooring

Wood flooring for condos and townhomes in Eden Prairie, MN, specified to your building's own documents and installed around your neighbors.

Eden Prairie Wood Flooring installs and refinishes condo and townhome flooring in Eden Prairie, MN and has been doing it for 20+ years. Attached homes are a large part of this market: nearly a quarter of the city’s owner-occupied units are one-unit attached, which is several times the share in most of the surrounding cities. That means the jobs where somebody lives directly below the floor are normal work here rather than an occasional exception.

What makes an attached home different is not the flooring. It is everything wrapped around it. The building’s own documents may decide what you are allowed to install, an acoustic underlayment may be specified before a board can be ordered, the approval runs on a board’s meeting schedule rather than yours, and the route to the unit runs through a corridor and an elevator that belong to everybody.

So we start with the paperwork rather than the product. We read your declaration, bylaws and rules, prepare the underlayment specification in the form the board expects, and get the answer in writing before dates are held. That ordering costs a couple of weeks once. Skipping it is how a scheduled installation becomes a cancelled one, with a delivery of flooring already sitting in the unit.

What Your Association Actually Controls

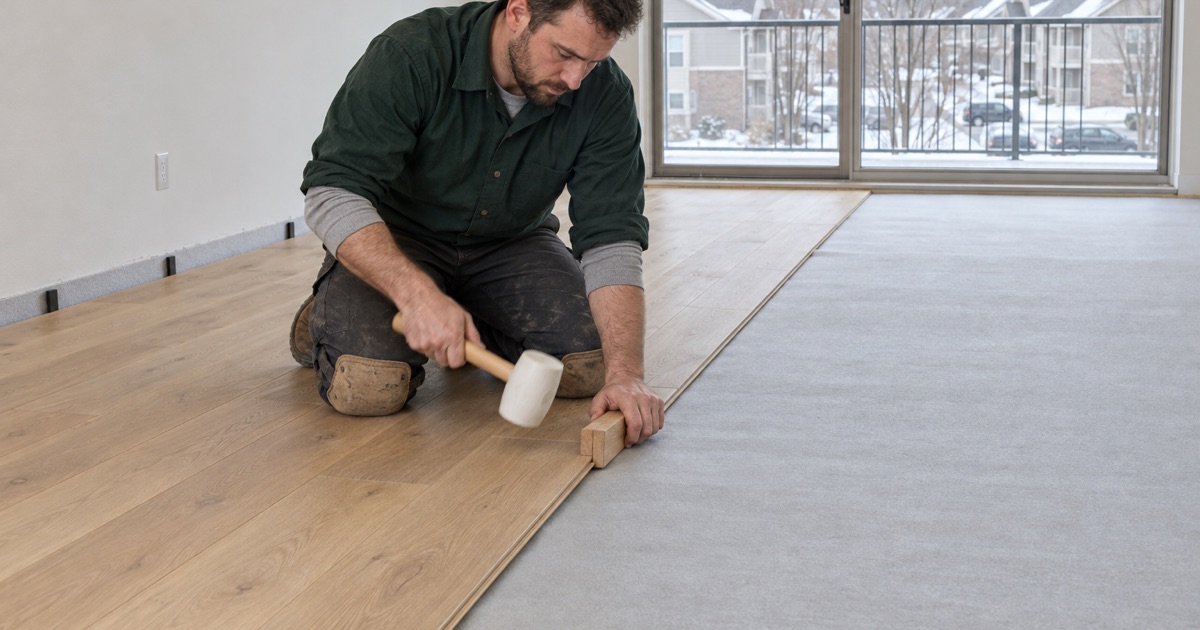

Installer striking a tapping block against the exposed edge of an engineered white oak plank in an Eden Prairie condominium, the acoustical mat running out ahead of the work.

Declaration, Bylaws and Rules

Common interest communities in Minnesota are governed by their recorded declaration and bylaws, and those documents routinely reach the floor covering in an upper-level unit. They may name a permitted assembly, require an acoustic layer, restrict hard surfaces in certain rooms, or say nothing at all. The only way to know which applies to your building is to read them, and buildings a block apart regularly differ.

Written Approval Before Work Starts

Where approval is required, it is generally required before work rather than after, and it is granted at a board meeting on the board’s own calendar. We submit the flooring and underlayment specification early, in writing, and wait for the decision before scheduling. An approval chased after installation puts the owner in the worst possible position, because the remedy the association can ask for is removal.

Minnesota Sets No Single Sound Rating

The sound part of the Minnesota rules people still cite at each other was repealed, and the numbers circulating online come from an archived pre-repeal version. We do not present any statewide impact or sound figure as a legal requirement, because there is not one to present. What binds your job is your building’s documents, which is both narrower and far more useful than a number lifted from a search result.

Acoustic Underlayment and Sound Ratings

Impact Insulation Class and Sound Transmission Class

Impact insulation class describes how well an assembly resists footfall and dropped objects passing through to the unit below; sound transmission class describes airborne noise such as voices and television. Both are laboratory measurements taken under defined test methods on a complete assembly. An underlayment on its own does not carry a rating in any meaningful sense, which is why the spec sheet has to be read rather than skimmed.

Reading a Spec Sheet Against Your Building

A number achieved over a six-inch concrete deck tells you very little about the same product over a wood-framed floor with a drywall ceiling below. We compare the tested assembly on the sheet against what your building actually has, and match it to the rating your declaration asks for. Where the published test does not resemble your construction, we say so instead of passing the number along.

Underlayment Thickness and Floor Height

Every acoustic layer adds height, and that height has consequences at the door, the appliance opening, the stair nosing and the threshold into an adjacent room. We measure at each of those points before ordering and plan the transition piece — reducer, T-mold or threshold — for each one. Planning it into the quote costs nothing; finding it afterward means re-hanging doors or pulling an appliance.

Flooring That Suits an Attached Home

Engineered Flooring and Floating Installations

Engineered construction moves less with humidity than solid wood and can be floated over an acoustic underlayment, which is frequently exactly what an association’s specification calls for. Floated floors also decouple the flooring from the structure, which helps with impact noise. The trade-off is feel and height, so we walk you through both rather than treating the product choice as settled by the specification alone.

Lower-Level and Slab-On-Grade Units

Walkout lower levels and slab-on-grade units sit on concrete, where solid hardwood is not recommended. Those rooms get tested in their own right with an in-situ relative humidity probe or a calcium chloride test, and the vapor retarder, adhesive and product are specified from that result. A reading taken on an upper floor says nothing useful about the slab, and quoting off it is how the same floor fails twice.

Prefinished Against Site-Finished in an Occupied Building

Prefinished flooring arrives coated, which removes the sanding and finishing days from an occupied building entirely and puts the unit back in use fastest. Site-finished work allows any color and a seamless surface but brings machines, dust and cure time into a shared building. In an occupied association, that difference often matters more than the appearance of the finished floor, and we price both.

Working in an Occupied Building

Corridors, Elevators and Shared Access

Material, equipment and debris all travel through space that belongs to everyone, and most associations have rules about how. We arrange elevator protection and access times with management ahead of the job, keep the corridor clear and covered, and remove waste rather than staging it in a shared area. It is unglamorous and it is most of what separates a smooth job from a complaint.

Dust, Noise and Working Hours

Vacuum-shrouded drum sanders, edgers and buffers take the great majority of the dust at the tool, and we contain the unit as well, but a sanding day is still a noisy day for the neighbors. We agree permitted hours with management, do the loud work inside them, and let the surrounding units know what is happening and when. A neighbor who was told in advance rarely calls anyone.

Unit Turns and Handover Dates

For a rental unit the flooring has to be finished, cured and ready before the next tenant arrives, not merely installed. We build the schedule backward from the handover date, choose a finish whose cure time fits the window, and give the property manager written dry and cure times including what an unheated vacant unit does to them. That is a date a leasing office can actually rely on.

  • 20+ Years Experience
  • Free Written Quotes
  • Moisture Readings on Every Quote

Good to know

Frequently Asked Questions

Do I need approval before replacing carpet with hardwood?

In most attached buildings, yes, and the requirement lives in your declaration, bylaws and rules rather than in state law. Many associations ask for a written request naming the flooring and the acoustic underlayment, and some require approval in writing before any work begins. We read your building's documents, prepare the specification in the form the board expects, and wait for the answer before a crew is scheduled.

Does Minnesota require a particular sound rating for hardwood in a condo?

No. The sound provision of the Minnesota rules that is still widely quoted online was repealed, and the figures circulating come from an archived version rather than current law. That means the governing requirement is your own building's documents, which frequently do name a rating. It also means a contractor citing a statewide number is quoting something that no longer exists, which is worth knowing before you rely on it.

What does acoustic underlayment do to my floor height?

It raises it, usually by a few millimeters to several, depending on the product the board requires. That height shows up at door bottoms, appliance openings, the stair nosing and every threshold into carpet or tile. We measure the finished height at each of those points before ordering anything and plan the reducer or T-mold at each transition, so nothing has to be cut or re-hung after installation.

Can I have solid hardwood in a lower-level or slab-on-grade unit?

Solid hardwood is not recommended over a concrete slab, and that covers most walkout lower levels and slab-on-grade units. Engineered flooring is the product for those spaces, installed once the slab has been tested with an in-situ relative humidity probe or a calcium chloride test and shown to sit inside the manufacturer's limits. We take that reading in the room itself rather than borrowing a number from upstairs.

How disruptive is the work for my neighbors?

Less than most people fear, if it is planned. Sanding is the noisy part and is confined to specific days; the coating days are quiet. We agree working hours with management in advance, protect and keep the shared corridor and elevator clear, and run vacuum-shrouded sanding equipment with the unit contained. Telling the neighbors what happens on which day usually does more good than any equipment choice.

Can flooring be done inside a unit turn window?

Often, and the number that governs it is cure time rather than sanding time. A finish that is dry is not necessarily ready for furniture or a new tenant's rugs, and an unheated vacant unit lengthens the wait. We schedule against the handover date, choose a finish whose cure fits the window, and put those times in writing so the leasing office is working from real dates.

Ready to Get Started?

Request a free quote today and we'll get back to you fast.
